Cass Square playground is a community facility that provides recreation and play opportunities for families in Hokitika.
Concerns were raised by the community regarding the standard of the play equipment and improvements were requested. An audit of the playground and equipment found that there were improvements to be made. During the Long Term Plan process in 2021 Council allocated $628,000 over the next 10 years for playground equipment and rubber matting upgrades, as well as ongoing maintenance.
Timeline
April | Cass Square playground was audited by an external consultant, standards of failure and required improvements were identified. |
June | Council allocated funding in the LTP to start work on improvements to the playground. |
September | Staff appointed The Playground Center to provide initial designs. |
April | Council agreed to investigate applying for additional Lotteries Funding and put the project on hold while the funding is secured. |
September | Application submitted to Lottery Grants Board. |
November | Annual Playsafe Playground inspection found 4 low risk issues, 31 low/medium risk issues, 14 medium risk issues and 4 high risk issues. High risk issues come with a recommendation for closure or immediate rectification. |
December | Lotteries Grant approved. |
January | Working group, including community members appointed. |
March |
Working Group workshop
|
April |
Working Group workshop
|
June |
Working Group workshop
|
Council budgeted $521,460 in the 2021/2022 year for the renewal and upgrade of the Playground and surfaces at Cass Square. In the draft Annual Plan Council proposed carrying the budget into the 2022/2023 financial year.
By seeking additional funding the community will get the benefit of a larger facility without further community funding requirement.

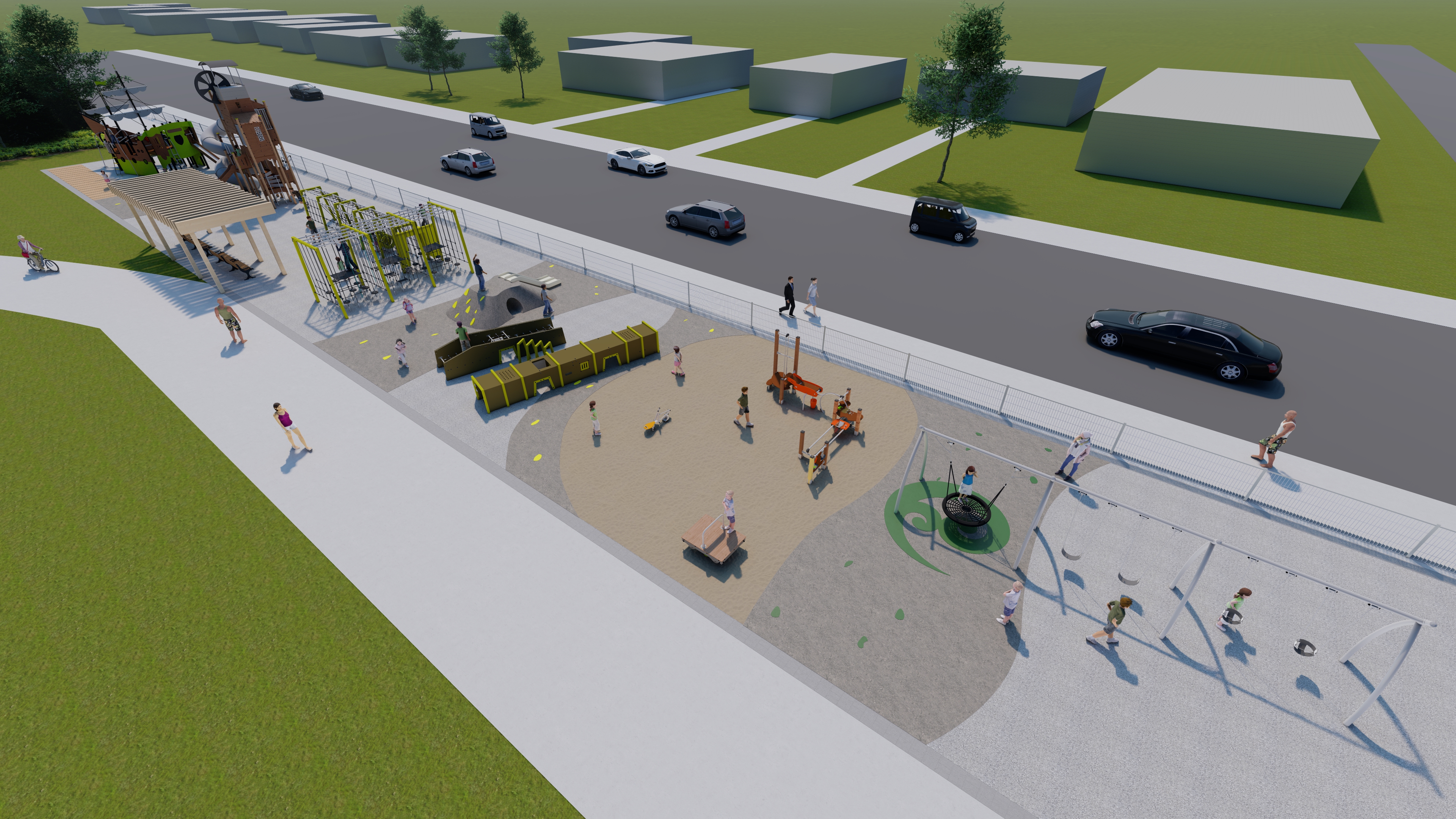

A draft design has been completed and further discussions are ongoing with the community. The working group is considering the best options for the playground and preferred equipment, and researching sources of additional external funding.
Playground equipment currently has approximately 5 month lead time from order to availability.
